On a large industrial construction project, a foundation can be completed exactly as per the approved drawing and still create problems during equipment installation. The reason may be a late change in anchor-bolt locations, an uncoordinated embedded conduit, or a mismatch between the civil contractor’s scope and the equipment supplier’s requirements. By the time the conflict becomes visible at the site, correcting it may require rework, additional cost, and disruption to the construction schedule.
Such problems often arise not because any single team has failed to perform its work, but because the connections between different teams and their responsibilities were not properly identified and managed.
This is where interface analysis becomes essential. It helps project teams systematically identify who needs to coordinate with whom, what information must be exchanged, and which technical or contractual issues must be resolved before they affect construction. For civil engineers working on complex industrial projects, understanding this process is crucial to ensuring that independently executed work packages come together without unnecessary conflicts, delays, or rework.
What Is Interface Analysis?
Interface analysis is a systematic process of identifying the parties involved in a project, understanding their relationships, and determining the areas where their work, responsibilities, or information requirements overlap.
In a complex industrial project, no contractor operates entirely independently. Civil works depend on design inputs, structural steel depends on foundation readiness, mechanical installation depends on equipment and supporting structures, and electrical and instrumentation works depend on the availability of equipment, cable routes, and installation details.
These relationships create interfaces. If they are not properly identified and coordinated, they can lead to rework, delays, disputes, and safety risks.
The objective of interface analysis is to break down this complexity into manageable elements so that the project team can establish a structured system for coordinating and controlling interactions throughout the project lifecycle.
Why Is Interface Analysis Important?
Consider the construction of a pellet plant in an integrated steel plant project. The work may involve civil contractors, structural steel contractors, equipment suppliers, mechanical installation teams, electrical contractors, instrumentation specialists, and commissioning personnel.
A delay in one activity can affect several others. For example, if the equipment supplier changes the foundation loading requirements after the RCC foundation has been cast, the project may require structural reassessment, remedial work, and rescheduling of equipment erection.
Early interface analysis helps identify such dependencies and establish clear communication and coordination arrangements before work begins.
Its major benefits include:
- Reduced rework: Identifies conflicting requirements before construction or installation.
- Better schedule control: Highlights activities that depend on inputs or completion by other parties.
- Clearer responsibilities: Establishes who must provide information, take action, and coordinate each interface.
- Improved quality and safety: Helps prevent incompatible designs, installation conflicts, and unsafe work sequences.
- Better risk management: Identifies interface-related risks early enough for corrective measures to be planned.
- Stronger project coordination: Connects interface management with quality, document control, project scheduling, and risk management.
A Practical Four-Step Approach to Interface Analysis
Interface analysis follows a top-down approach. Instead of trying to manage every individual interaction immediately, the project team first examines the overall project structure and progressively narrows its focus.
1. Identify the Interface Networks
An interface network is a group of project entities connected by a common purpose or type of interaction.
Large projects usually contain several networks because not every party needs to coordinate with every other party on every subject.
For example, an integrated steel plant may establish the following networks:
- Contractor-to-contractor network: Coordinates interfaces between civil, structural, mechanical, and electrical contractors.
- Project-to-existing-system network: Addresses connections with existing utilities, roads, drainage systems, or operating facilities.
- Project-to-project network: Coordinates common infrastructure and shared facilities between different plant units or packages.
- Contractor-internal network: Manages interfaces between engineering, procurement, construction, and commissioning teams within a major contract.
The exact networks should be determined from the project’s scope, contract strategy, organizational structure, execution plan, and technical requirements.
For example, the pellet plant and filtration plant may be separate construction packages but share a common utility corridor, storm-water drainage system, or access road. Their shared requirements should be managed through an appropriate interface network rather than left to informal coordination.
The important point is that interface networks should reflect the actual structure and dependencies of the project, not simply follow a standard template.
2. Identify the Interface Parties and Their Responsibilities
Once the networks have been identified, the next step is to determine which parties must interact within each network.
These parties may include the owner, engineering consultant, main contractor, subcontractors, equipment suppliers, testing laboratories, utility providers, and commissioning teams.
The project team must understand not only who is involved but also how their responsibilities are connected.
A useful technique is the Interface Entity Relationship (IER) model. It visually represents the entities within a network and the relationships between them. This helps the team understand where coordination is required and which parties may be affected by another party’s decisions or delays.
For instance, consider a foundation supporting a heavy industrial machine. The civil contractor may be responsible for RCC construction, the equipment supplier for foundation loading and anchor-bolt details, and the mechanical contractor for equipment installation.
Their responsibilities are different, but their work is closely connected. The foundation cannot be constructed correctly without approved loading information and coordinated anchor-bolt details.
Another important concept is the Lead Interface Party (LIP). This is the party assigned responsibility for leading and coordinating a particular interface group.
The lead interface party should be clearly identified so that coordination does not depend on assumptions about who is responsible. Its precise duties and authority should be established in the project’s interface management procedure or contractual arrangements.
Using an Interface Group Matrix

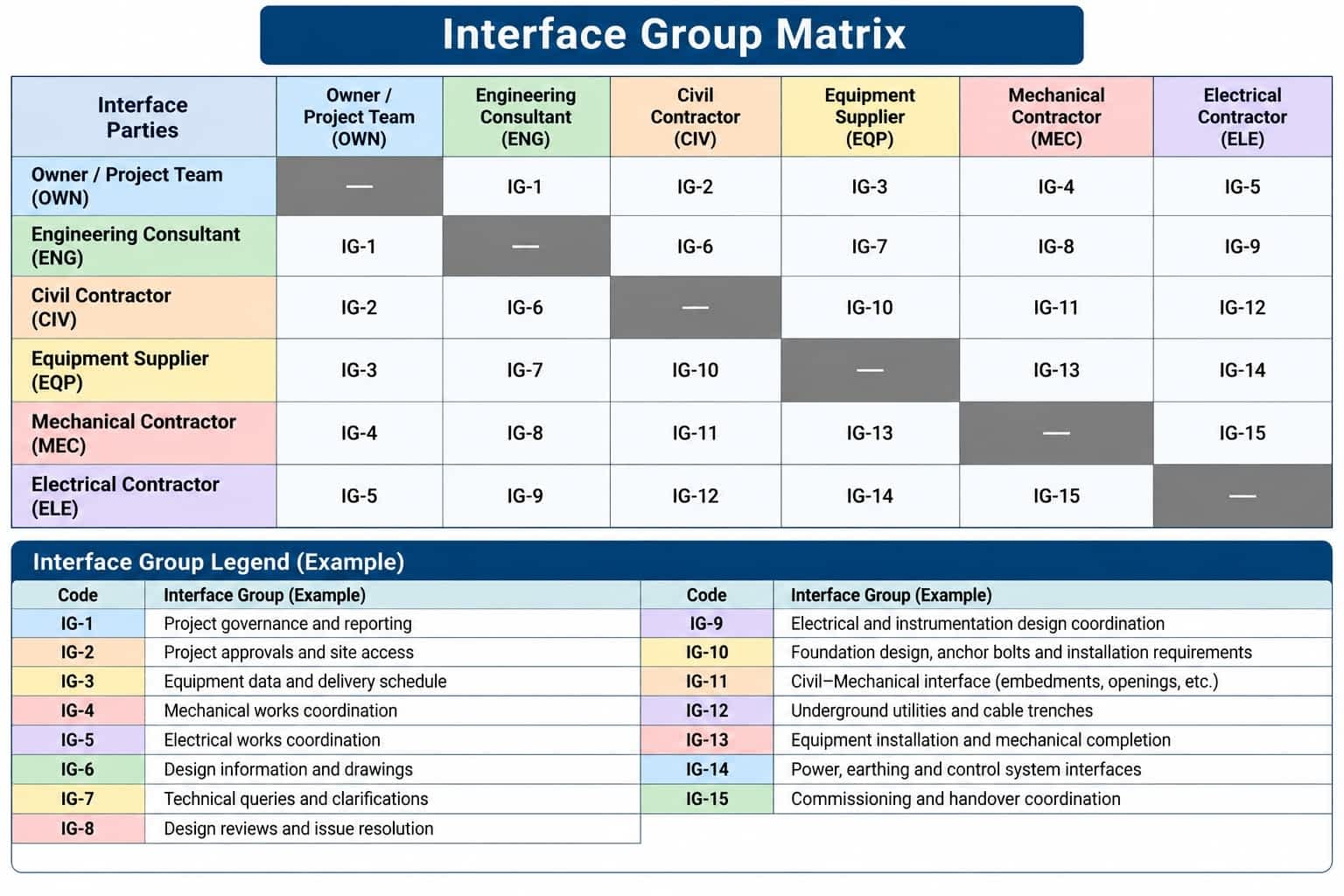

An interface group matrix provides a structured way to record these relationships.
The matrix lists the relevant parties and identifies their interface relationships, including the party responsible for leading each interface group. An example of this approach is illustrated in the source material’s interface group matrix.
In an industrial construction project, such a matrix can help identify the coordination required between the civil contractor, equipment supplier, structural contractor, and mechanical installation team.
It also makes gaps in responsibility easier to detect. If two parties depend on each other but neither has been assigned responsibility for coordinating the interface, the project team can address the gap before it becomes a site problem.

3. Define the Interface Areas
After identifying the parties, the next question is: What exactly do they need to coordinate?
Interface areas define the subjects or domains in which interaction is necessary. These may relate to technical disciplines, physical systems, subsystems, procurement packages, or specific equipment and installation nodes.
For an industrial construction project, relevant interface areas may include:
- Civil and structural engineering
- Geotechnical and foundation design
- Mechanical equipment installation
- Electrical power distribution
- Instrumentation and control systems
- Water supply and drainage
- Fire protection and safety systems
- Construction sequencing and project scheduling
- Quality assurance and document control
Consider a large equipment foundation in a steel plant. Its interface areas may include soil bearing capacity, equipment loading, anchor-bolt positioning, foundation top level, grout thickness, embedded conduits, and equipment installation tolerances.
These requirements involve several disciplines and parties. Defining them as interface areas helps the project team focus coordination efforts on the specific information and decisions required.
There are two useful approaches to defining interface areas.
Predetermined approach: Uses a standard set of disciplines or systems based on previous projects or established industry practices. This is useful when the project resembles earlier projects.
Specified approach: Defines interface areas according to the particular needs of the project. This is especially useful for unique facilities, unusual equipment, or complex construction arrangements.
In practice, a project may use both approaches. Standard disciplines can provide a starting point, while project-specific interface areas address unusual or high-risk requirements.
4. Identify the Interface Issues
Identifying the parties and interface areas establishes the framework, but the analysis is incomplete until the actual interface issues are identified.
An interface issue is a specific matter requiring coordination, clarification, agreement, or action between parties. It may involve physical connections, technical requirements, information exchange, construction sequence, or responsibility boundaries.
For example, the following are potential interface issues in an industrial construction project:
- The equipment supplier’s anchor-bolt layout does not match the approved civil foundation drawing.
- The structural contractor requires foundation handover before the civil contractor has completed dimensional verification.
- Underground piping conflicts with an RCC foundation or cable trench.
- The electrical contractor requires embedded conduits before concrete pouring, but the coordinated drawing is not approved.
- The drainage contractor’s proposed invert levels conflict with the required road levels or underground utilities.
- A change in equipment loading requires reassessment of a foundation that has already been constructed.
Each issue should be clearly described so that the affected parties understand the problem and the action required.
For effective management, the project team should record the issue, responsible parties, lead interface party, required information or decision, target resolution date, and current status in an interface register.
This makes interface issues traceable and helps prevent important matters from being forgotten during fast-paced construction activities.

Prepare Before Starting the Analysis
A thorough interface analysis requires more than site observations and coordination meetings. It depends on a sound understanding of the project and its execution strategy.
Before starting, the responsible team should review relevant project documents, including:
- Project execution plan and project mandate
- Contract strategy and scope-of-work documents
- Organization charts and responsibility matrices
- Design drawings and technical specifications
- Project schedule and construction sequence
- Existing facility and utility information
- Quality management, risk management, and document control procedures
The team should also identify assumptions, constraints, missing information, and uncertainties that could affect the analysis.
For example, if a common underground utility corridor is planned for multiple plant units but the final routing is not approved, this uncertainty should be recognized early. The affected contractors and design disciplines can then be identified, and the required decisions can be planned before excavation or foundation construction begins.
The people responsible for the analysis must also understand the project’s organization, decision-making process, contractual obligations, and existing management systems. Without this preparation, the resulting interface arrangements may overlook important responsibilities or conflict with established project procedures.
Use Interface Analysis Throughout Project Execution
Interface analysis is not a one-time exercise that ends when planning is complete.
Although the initial analysis should be carried out during project initiation and planning, the findings must remain relevant as engineering, procurement, construction, and commissioning progress.
Industrial projects frequently undergo design changes, scope revisions, contractor mobilization, and changes in construction sequence. Each of these can introduce new interfaces or alter existing ones.
For example, a late change in the layout of a process unit may affect foundations, underground utilities, structural steel, equipment access, and cable routing. The project team must reassess the affected interfaces and update the relevant records.
The analysis process should therefore be iterative. As new information becomes available, the project team should review interface networks, parties, interface areas, and issues to ensure that the coordination arrangements remain effective.
The client or project owner should establish the overall interface management requirements, while individual contractors may perform similar analyses within their own scopes. However, contractor-level arrangements must remain aligned with the project’s overall interface management system.
The outputs should also be connected with other project processes, including risk management, quality management, document control, planning and scheduling, and change management. Where the number of interfaces is large, an automated interface register can improve tracking, accountability, and reporting.
Conclusion
Large industrial construction projects are complex not only because of their technical requirements but also because of the numerous relationships between the people, organizations, disciplines, and systems involved.
Interface analysis provides a structured way to understand this complexity. By identifying interface networks, defining the parties and their responsibilities, establishing relevant interface areas, and recording specific interface issues, project teams can identify coordination gaps before they turn into costly problems.
For civil engineers, this means looking beyond the immediate construction activity and understanding how each foundation, structure, utility, and work package affects the activities of others.
A project is not successful merely because each contractor completes its individual scope. Success depends on how effectively those scopes connect and function together as one integrated system.
Also Read: Project Interface Management to Prevent Delays and Reworks
